Stages
Your board's columns — their status, win probability, rotting window, colour and order.
Stages are the columns of your board, and they are the board's own — a stage exists on one pipeline and nowhere else. Manage them at the top of Pipeline settings.

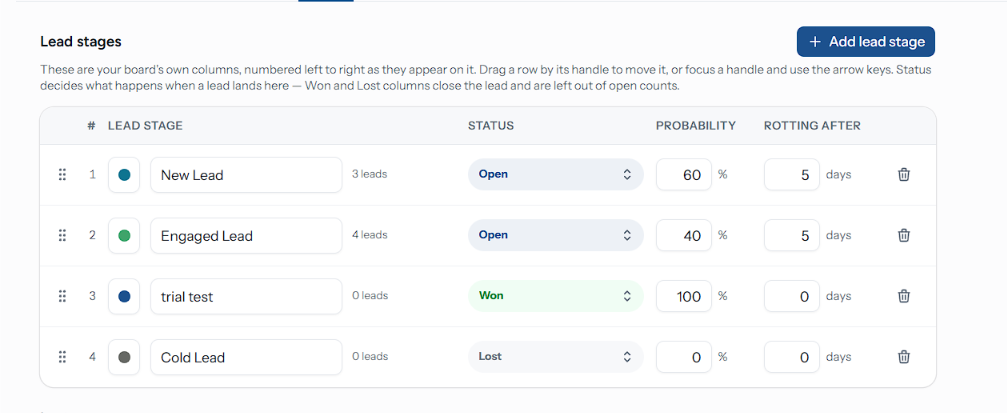

What a Stage Carries
| Field | Does |
|---|---|
| Colour | The left edge of every card in the column, and the dot beside its name. Picked from a fixed palette |
| Stage | Its name, everywhere on the board. Blanking the field reverts it |
| Status | Open, Won or Lost — what landing here does to a lead |
| Probability | 0–100. Weights the Forecast and shows as "{n}% likely" on the column |
| Rotting after | Days of silence before a lead here is flagged. 0 means never |
The row also shows how many leads the column holds. Number and text fields save when you click away from them; the colour and status selects save immediately.
Status is the one field that changes behaviour rather than presentation. Switching an ordinary column to Won or Lost makes every future drop onto it close a lead — and leaves the leads already sitting there untouched, so the column's status and its contents can disagree until they are moved.
What a New Board Starts With
Creating a pipeline gives you seven columns and five lost reasons. All of them are editable, and none of them are special.
| Stage | Status | Probability | Rotting after |
|---|---|---|---|
| New Lead | Open | 10% | 3 days |
| Contacted | Open | 25% | 4 days |
| Qualified | Open | 45% | 5 days |
| Demo / Proposal | Open | 65% | 7 days |
| Negotiation | Open | 80% | 5 days |
| Won | Won | 100% | — |
| Lost | Lost | 0% | — |
An organisation that had lifecycle stages before the pipeline shipped gets a board whose columns carry those names instead, sorted into open, then won, then lost.
Adding and Ordering
Add stage appends a column called New stage at 50% and a 5-day rotting window. Rename it in place straight away — the name is stored, so the whole organisation sees whatever you leave there.
Set its Status. This is the field to get right: a new stage defaults to Open.
Reorder by dragging a row's grip handle, or by focusing the handle and pressing the arrow keys. The number on the left is the column's position, left to right on the board.
A one-column board offers no handles and no delete — there is nothing to reorder, and a pipeline must keep at least one stage. The delete button's tooltip says so.
Deleting a Stage
Deleting asks where the leads in it should go: Move its leads to a column you pick. Nothing is deleted with the stage, and the leads keep their notes, timelines and assignees — they simply land somewhere else.
Lost Reasons
Under the stages table, Lost reasons is the list your team picks from when marking a lead lost. Each row shows how many leads have been attributed to it. Add reason appends one; the bin removes it.
A new board starts with Price too high, No response, Chose a competitor, Not the right fit and Timing — revisit later.
Deleting a reason is not blocked by the leads already using it, and the count beside it is your only warning. Rename a reason you have outgrown rather than deleting it, or its share of your historical losses becomes unattributable.
Choosing Windows That Work
- Match the window to the step, not the board. A first reply is late after two days; a proposal under review is not late after two weeks.
- Leave closing columns at zero. Nothing in them can be late — the lead is already done.
- Set probabilities that step up. They drive the forecast, and a board where three consecutive stages all read 50% forecasts nothing useful.
- Fewer columns than you think. Every column is a decision someone has to make about which one a lead belongs in.
